Knockdown-Rebuild Site Preparation Across Melbourne

Most volume builders will hand you a contract that starts the day the block is clear — and then charge you for every week it is not. Our job is to make that date, working backwards from your builder’s program rather than forwards from whenever we happen to be free.

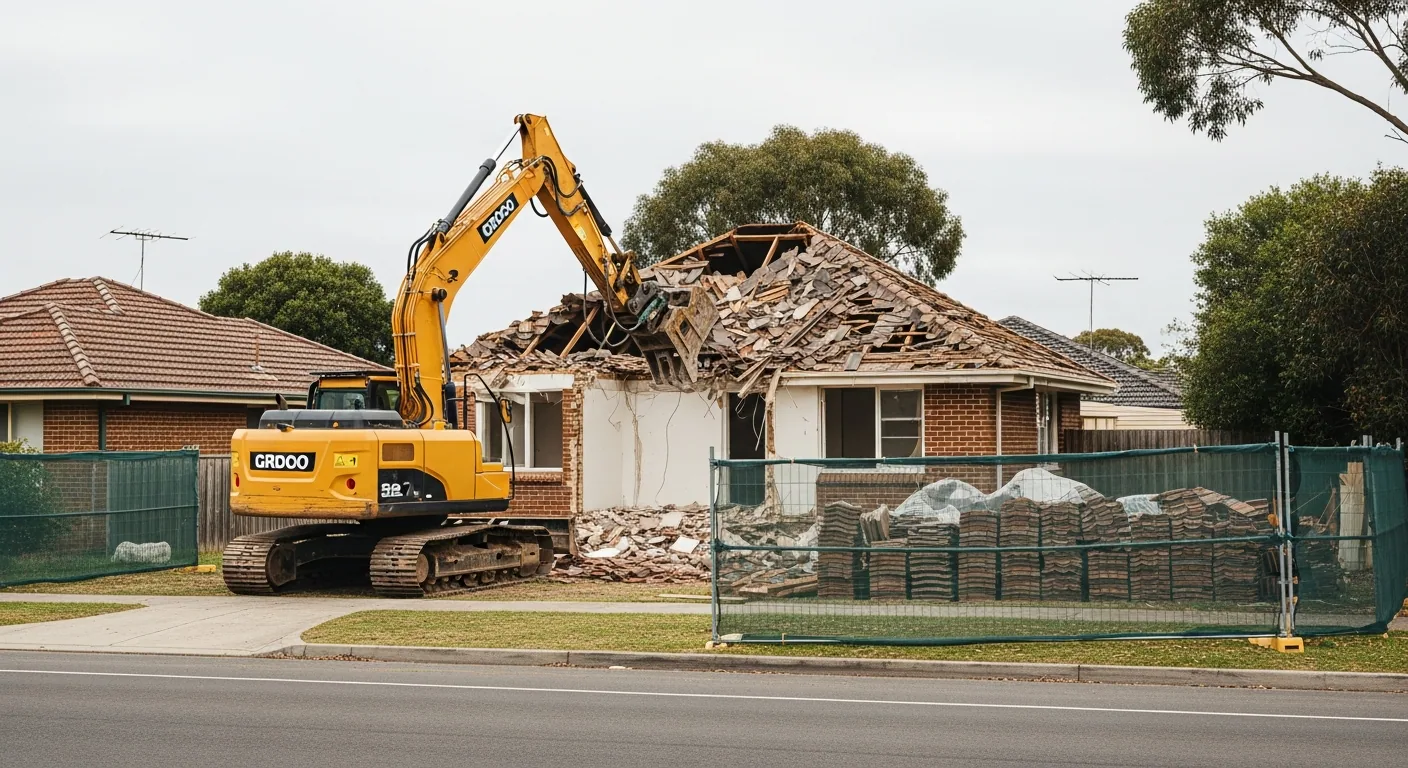

Single-storey brick home coming down behind temporary fencing, spoil dropping straight to the ground

Working to the builder's date, not ours

A knockdown-rebuild has one deadline that matters: the day your builder can put a surveyor on the block. Everything else is scheduling. Once we have that date we work backwards — abolishment applications first because they are the slowest, then the permit, then the asbestos, then the machines.

We will also tell you honestly if the date is not achievable. An electricity abolishment lodged in December is not going to be done in January, and no amount of chasing changes that. Knowing it in week one is worth far more than being told in week six.

Service abolishment is the long pole

Disconnection is not abolishment. Turning the power off at the meter does not let a machine near the building — the supply has to be physically removed and the distributor has to certify it. Depending on the distributor and the time of year, that is commonly four to eight weeks from lodgement, and it cannot be compressed by good intentions.

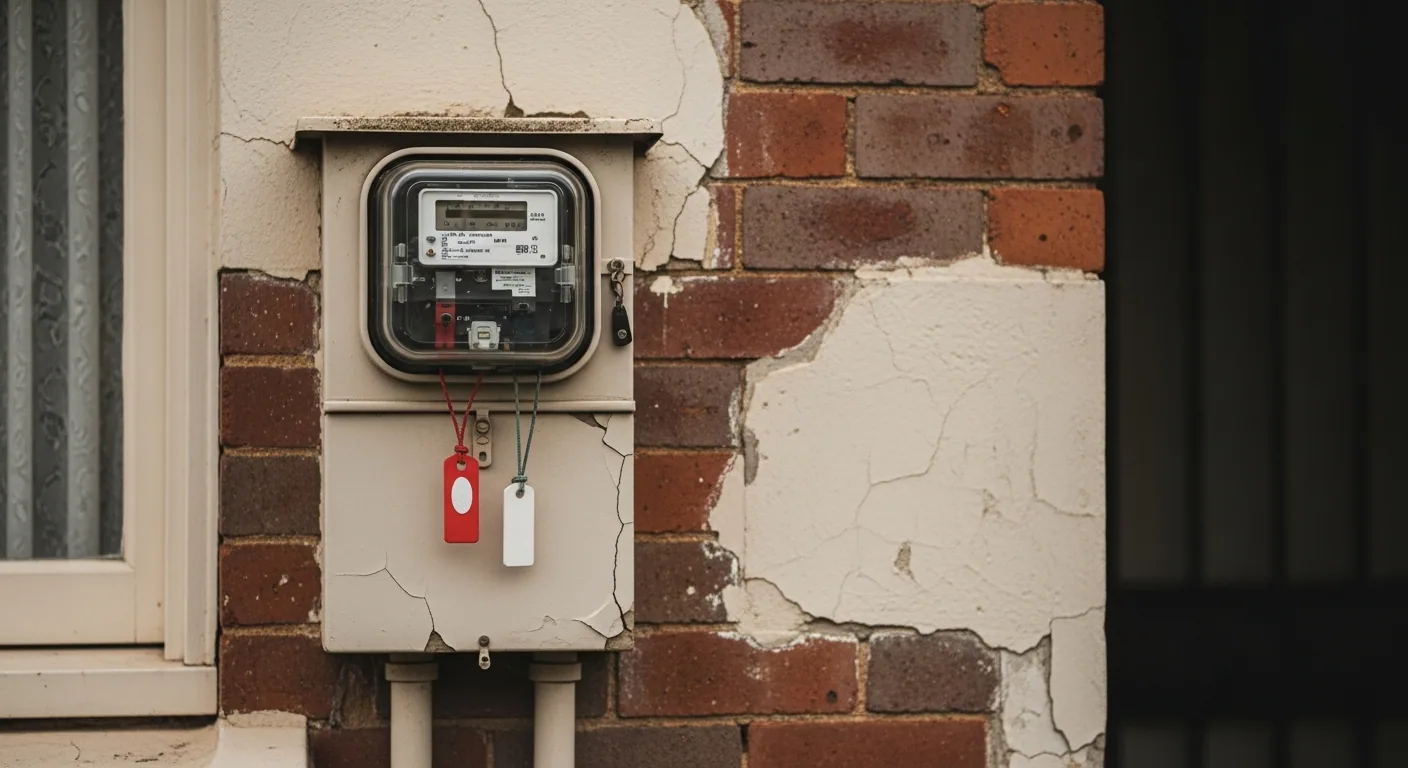

Electricity meter removed and the supply physically abolished ahead of demolition
Abolishment, not disconnection — the supply is gone from the building before anything mechanical goes near it.

We lodge and track:

- **Electricity abolishment** with the relevant distributor for your address — Citipower, Powercor, AusNet, United Energy or Jemena, depending on which side of Melbourne you are on - **Gas abolishment** back to the main, not just a meter removal - **Water** meter removal and, where the new build needs it, the disconnection or capping arrangements your plumber will ask about - **Telecommunications** — the old copper lead-in and any NBN equipment on the building

What we need from you

Proof of ownership, a site plan or title, and your builder's contact. That is genuinely most of it. Distributors will not accept an abolishment application from a contractor with nothing linking them to the property, so the paperwork has to name you properly — we prepare it, you sign it.

Clearing to a level your surveyor can use

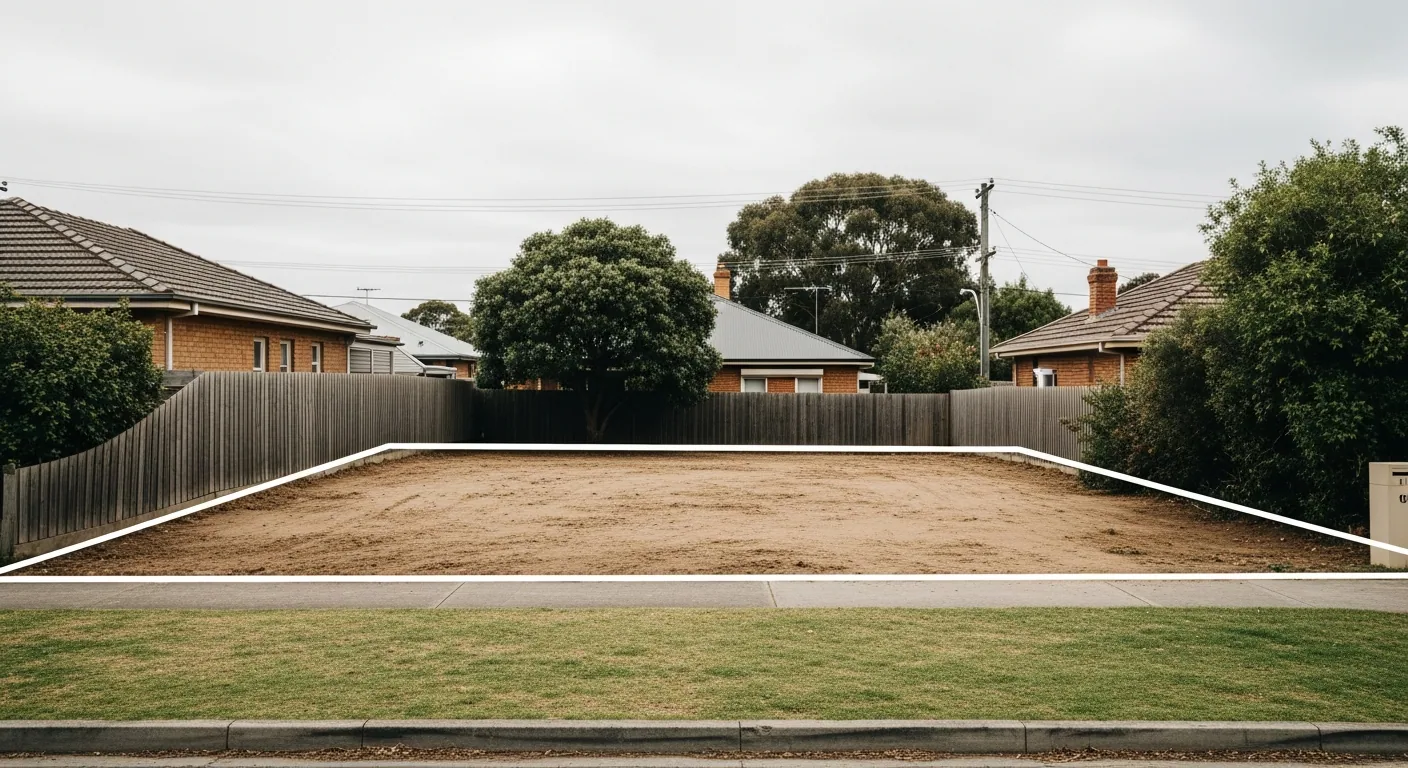

Levelled, compacted block with the site fence still standing, ready for survey set-out

The handover point is a block cleared, grubbed, levelled and compacted, with the site fence still up and a clean crossover. We photograph the finished levels and mark where old services ran, because six weeks later when the plumber is looking for a sewer point, nobody remembers.

If your build needs a cut-and-fill, retaining removal or a rock report, that is a conversation to have while the machines are still on site — bringing them back is the most expensive way to do it.

Sequencing around a demolition permit

We can quote and program the work before your building permit for the new dwelling is issued, and in most cases the demolition permit and the report and consent under Section 29A run in parallel with your builder's documentation. Starting that early is the single biggest lever on your overall timeline.

Why choose us for knockdown-rebuild site preparation

  • Program built backwards from your builder’s start date
  • Electricity, gas, water and telecom abolishment lodged and tracked
  • Demolition permit and Section 29A consent handled in parallel
  • Block cleared, grubbed, levelled and compacted for set-out
  • Old service runs photographed and marked before handover
  • Direct contact with your builder or project manager
Need knockdown-rebuild site preparation in Melbourne?
FAQs

Knockdown-Rebuild Site Preparation — common questions

How early should I book demolition for a knockdown-rebuild?

As soon as you have a builder and a rough start date — ideally three months out. The site work is quick; the abolishments and approvals in front of it are not, and they are the reason most rebuild programs slip.

Can you deal directly with my builder?

Yes, and it usually goes better that way. Give us their site supervisor and we will handle sequencing, site access and the handover levels without routing every message through you.

What if my builder needs the block earlier than expected?

Tell us as soon as you know. Machine time can often be moved. Abolishment lead times generally cannot, so an earlier date is only real if the applications went in early enough to support it.
